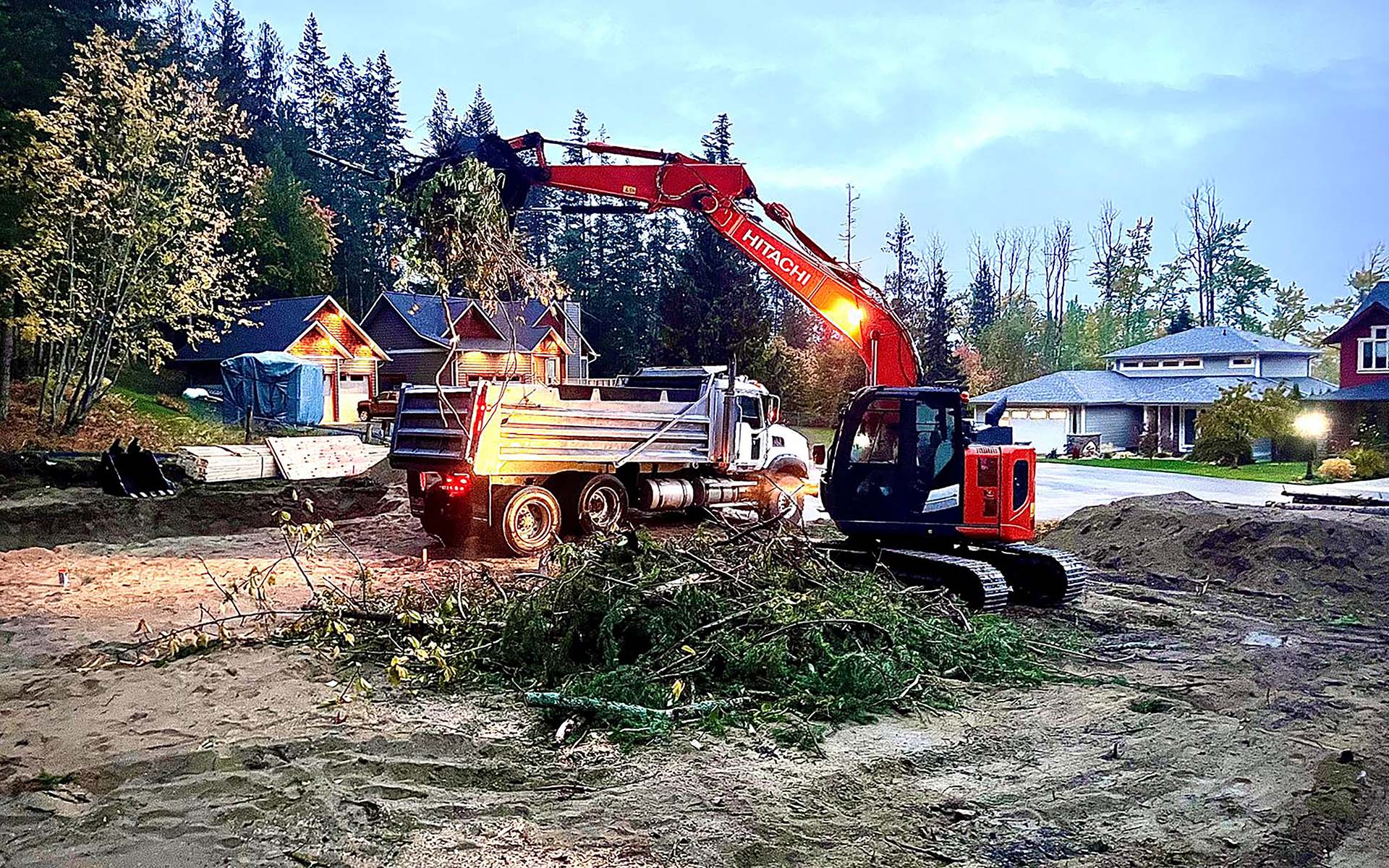

Introduction
Site preparation is one of those terms that gets used loosely. Ask ten people what it means and you'll get ten different answers — some think it's clearing a few trees, others think it's just leveling the ground, and a few assume their builder handles it automatically. In practice, proper site prep is a distinct phase of work that determines how well everything built on top of it will hold up over time.
At Winco Earthworks, site preparation is often the first thing we do on a new project — and for good reason. The decisions made during site prep affect drainage, structural stability, how smoothly the construction phase runs, and what kind of maintenance you're looking at years down the road. Getting it right costs less than fixing it later.
What Site Prep Actually Covers
Site preparation is the full sequence of work required to transform raw or undeveloped land into a stable, properly graded, and well-drained platform for construction. That typically includes land clearing, topsoil stripping, rough excavation and grading, drainage planning and installation, subgrade compaction, and establishing access routes for the equipment and trades that follow. On some properties it also means rock breaking, debris removal, or stabilizing soft ground before any building can happen.
Depending on the scope of your project, site prep may take a day or several weeks. What it always requires is a clear understanding of the property — the terrain, the soil, the drainage patterns, and what's planned to go on top — before any equipment starts moving dirt.
What Makes the Shuswap Different
The Shuswap isn't a forgiving environment for shortcuts. The soil conditions across the region vary considerably — from the silty clay-heavy valley floors to the sandy benches above the lake, to the rocky till on the steeper hillsides — and each presents its own set of challenges. Add in the climate: winters that drive frost well into the ground, significant spring snowmelt, and the wet spring conditions that arrive just when most people want to start building. A site that wasn't properly prepared for these realities will show it quickly.
We've been doing site preparation work throughout the Shuswap since 2014 — on everything from compact lakefront lots to multi-acre rural parcels — and we understand how local conditions affect what needs to be done and in what order.
Key Takeaways
Before getting into the details, here are the most important things Shuswap property owners should know about site preparation:
- Site prep is a distinct phase, not a part of the build — In most cases it happens before your builder or foundation contractor arrives on site. Treating it as an afterthought is one of the most common — and most costly — mistakes on new construction projects.
- Shuswap soil conditions vary significantly across the region — The valley floor has dense clay and silt left behind when ancient glacial lakes drained away. The benches above tend to be sandier and coarser. Hillside properties often sit on rocky glacial till mixed with boulders. Each behaves differently under load and water, and each requires a different approach.
- Topsoil removal is non-negotiable — Organic material compresses over time, holds moisture, and cannot support a structure. Stripping it out — typically 12 to 18 inches — before anything is built is one of the most important steps in the entire process.
- Drainage design happens during site prep, not after — The slopes, swales, drainage channels, and culvert placements that manage water on your property need to be established before the build starts, not retrofitted once water problems appear.
- Compaction must happen in layers — Fill material and subgrade cannot be compacted all at once. Each lift must be compacted before the next one goes down. Skipping this step leads to settlement that no amount of surface work can fix.
- Land clearing is more than cutting trees — Stump removal, root grinding, brush disposal, and debris management are all part of clearing a site properly. Stumps and organic debris left in the ground will rot and settle, creating voids under whatever is built above them.
- Access route planning matters — A site that your equipment can reach and maneuver on saves time and money throughout the entire project. Getting that access established early — including temporary haul roads if needed — makes every phase easier.
- Related work should be sequenced correctly — Driveways, foundations, septic systems, and drainage infrastructure all connect to site prep. Understanding the right order to do things prevents having to redo work or damage completed sections during later phases.
- Spring is the ideal time to plan — not wait — Ground conditions in late spring allow proper excavation and compaction. Waiting until mid-summer means working in harder, drier conditions; waiting until fall means risking wet ground and shortened windows.
- CSRD permits may be required before work starts — Depending on the scope of clearing and grading, building permits or development approvals from the Columbia Shuswap Regional District may be needed. We can help you identify what applies to your site before work begins.
Understanding Shuswap Soils
The Shuswap sits on a mix of soils left behind by glaciers that retreated from this landscape roughly 13,000 years ago. Understanding what's under your property isn't just interesting background — it directly determines how your site needs to be prepared and what it can support.
Valley Floor: Dense Clay and Silt
Much of the Shuswap valley floor — particularly around Salmon Arm and Shuswap Lake's southern arm — sits on dense clay and silt that settled at the bottom of large glacial lakes as the ice retreated. These soils can look stable and firm when dry, but they hold water, expand when saturated, and compress unevenly under load. They're also particularly susceptible to frost heaving — water trapped in clay soils expands significantly when it freezes, and doesn't always settle back to the same position when it thaws.
On properties with valley floor soils, thorough organic removal, proper subgrade preparation, and well-designed drainage are not optional extras. They're the difference between a stable building platform and one that shifts every spring.
Lake Benches: Sands and Gravels
The elevated benches above Shuswap Lake — where many of the region's residential and agricultural properties sit — tend to have coarser, sandier soils: sands and gravels deposited by meltwater rivers as the glaciers retreated. These drain better and generally have better load-bearing capacity than the valley clays, but they're not without their own issues. Sandy soils can be loose and require compaction before building. They can also erode quickly on slopes if drainage isn't managed carefully during construction.
Hillsides: Glacial Till and Bedrock
Steeper hillside properties throughout the Shuswap often sit on glacial till — a mix of clays, silts, sands, gravel, and boulders deposited directly by glacial ice, with little sorting between particle sizes. Till varies widely from one area to the next and can hide large boulders just below the surface that complicate excavation. On some steeper slopes, bedrock is shallow and may need to be broken with hydraulic equipment before proper grading is possible.
Hillside properties also tend to have the most complex drainage situations — water running downslope needs to be intercepted and directed away before it can undermine a cut slope or building pad.
Organic Soils and Wet Areas
Low-lying areas, seeps, and land near watercourses often have a layer of organic soil — material that's largely composed of decomposed plant matter. Organic soil is compressible, holds significant water, and has virtually no load-bearing capacity. Any site prep work on land with organic soil requires stripping that material out entirely and replacing it with suitable mineral fill before anything structural is built above it.
The Site Preparation Process
Every site prep project is different, but the sequence of work follows a consistent logic — each step creates the conditions for the next one to be done properly. Here's how we approach it.
Site Assessment
Before any equipment is on site, we walk the property with you. We're looking at the terrain — where the slopes are, where water naturally drains, what the soil looks like at the surface, and where access is practical. We're also looking at what's going in: the building footprint, the driveway route, where the septic field is likely to go, and any retaining walls or drainage infrastructure that will be needed.
If the project is large enough or the soil conditions look uncertain, we may recommend bringing in an engineer or geotechnical consultant for a soil assessment before we start. That adds a step, but it prevents the more expensive problem of discovering unsuitable ground conditions once excavation is already underway.
The site assessment is also where we sort out permits. Depending on what's involved, you may need a CSRD building permit, a Ministry of Transportation access permit for a new driveway connection to a provincial road, or environmental authorizations if work is happening near a watercourse or wetland. We'll identify what's required and help you navigate the process.
Land Clearing and Debris Removal
Land clearing on Shuswap properties ranges from selective trimming around trees you want to keep, to full clearing of a heavily treed acreage. Either way, the goal is to remove everything organic from the building envelope — trees, stumps, brush, roots, and the topsoil layer itself.
Stumps are one of the most commonly overlooked issues on cleared land. A stump left in the ground will eventually rot, creating a void that causes whatever is built above it to settle unevenly. For stumps in the building envelope, removal is always the right call — not grinding, which leaves roots in the ground, but full extraction. Outside the building area, stumps can sometimes be handled differently, but it depends on what will eventually go over them.
Clearing also generates a significant volume of debris — brush, slash, logs, and stumps. Disposal needs to be planned in advance. Depending on the location and time of year, debris may be burned on site (subject to open burning rules), chipped, or hauled away. We discuss this during the initial assessment so there are no surprises.
For properties that have existing structures, old concrete pads, underground tanks, or other buried debris, demolition and debris removal becomes part of the clearing phase as well. Abandoned infrastructure has a way of becoming a problem during construction if it isn't identified and dealt with early.
Topsoil Stripping and Rough Grading
Once the surface vegetation and debris are cleared, the topsoil layer is stripped from the building envelope and stockpiled separately. Topsoil is organic material — it compresses under load and holds moisture. You cannot build a foundation, driveway, or septic field on top of it, regardless of how firm it looks. Stripping depth is typically 12 to 18 inches, but on sites with deep organic material it can be more.
With topsoil out of the way, rough grading begins: excavating and moving mineral soil to establish the grades shown on the building plan, creating the level building pad, shaping the terrain to direct drainage, and cutting the access routes. This is the phase where large volumes of material may move — cut from high areas and used to fill lower ones, or brought in from off site if the property doesn't have enough suitable material to achieve the required grades.
On hillside properties, rough grading often involves significant cut slopes and the beginning of any retaining wall construction. Those walls need to go in at the right point in the sequence — before the building pad is established above them, not after.
Drainage Planning and Installation
This is the phase that gets skipped most often and causes the most regret later. Drainage is not something you add after a building is in — the channels, culverts, swales, and grades that manage surface and subsurface water need to be established during site prep, while the ground is accessible and before anything permanent is in the way.
The work varies by site. On flat or gently sloping ground it might mean establishing a positive slope away from the building footprint, cutting shallow swales to intercept runoff, and installing culverts where a driveway crosses a drainage channel. On sloped properties it can mean more extensive ditch work, French drains, and engineered drainage to handle spring melt coming off higher ground.
In the Shuswap, we also pay attention to what happens in spring specifically — not just how a site drains during a summer rainstorm, but how it handles the combination of snowmelt, saturated ground, and rain that often arrives simultaneously in March and April. A drainage plan that only considers summer conditions will fail every spring.
Subgrade Preparation and Compaction
The prepared mineral subgrade — the soil surface that your foundation, driveway, or septic system will eventually sit on — needs to be compacted to achieve the density required by your building plans and engineering specifications. Compaction is not a single step: it happens in lifts. Each layer of material must be compacted before the next one goes down, at the right moisture content for the soil type. Compacting material that's too dry or too wet doesn't achieve the required density regardless of how many passes the equipment makes.
On sites with soft or problematic subgrade — saturated clay, organic pockets, or areas with high water tables — subgrade stabilization may be needed before compaction can achieve anything useful. That might mean undercut excavation and replacement with granular fill, geogrid reinforcement, or lime treatment of clay soils to improve their working properties.
On engineered projects, compaction testing confirms that the required density has been achieved before construction begins above it. This is a straightforward step that provides both the builder and the owner confidence that the foundation below meets spec.
Access Routes and Staging Areas
Getting materials and equipment to a site — and keeping the site workable throughout construction — depends on having adequate access. On raw land, that often means establishing a temporary haul road before any other work can start. On lots with limited frontage or tight access, it might mean coordinating with neighbours, setting up staging areas for deliveries, and planning carefully around what can fit where.
If a permanent driveway is part of the project, we typically rough it in during site prep so that the trades who follow have a usable access route. The final surface course goes on later, after all the heavy construction traffic has passed through.
"These guys are awesome, calm and professional. Easy to talk to, agree on things, and they do a great job explaining everything so the customer can understand what to expect. Highly recommend them."
— Levente G., Shuswap, BC
What Site Prep Sets Up
Site preparation doesn't happen in isolation. It's the foundation — literally — for everything else that goes on your property. The decisions made during site prep determine how well your driveway performs, how your foundation drains, where your septic field can go, and whether your site sheds water properly for the long term. Here's how the phases connect.
Driveways
The driveway route should be roughed in during site prep — before foundation work or septic installation begins — so there's a usable access route for all the trades that follow. A driveway built on a properly prepared subgrade, with the right drainage built in from the start, will outlast one that's dumped on unprepared ground by a significant margin. We've covered this in detail in our guide to gravel driveway construction in the Shuswap, but the short version is: preparation is everything. Learn more about our road and driveway work.
Foundation Excavation
Foundation excavation typically follows site prep once the rough grade is established. The building pad is ready, the access is in, and the drainage patterns are set — which means the excavator can dig the foundation to the right depth without fighting an ungraded site. On sloped properties, any retaining walls needed to support the building platform are constructed before the foundation goes in. Learn more about our foundation work.
Septic System Installation
Septic system placement is constrained by setback requirements, soil perc test results, and topography — none of which you have full control over. Knowing where the septic field will go before site prep begins lets you protect that area from heavy equipment traffic (which can compact the soil and compromise drain field performance), and ensures the grading around it sets up the right drainage relationships with the house and property. We handle septic installations as part of our broader scope of work, which makes the sequencing straightforward. Learn more about our septic system work.
Site Drainage
The drainage infrastructure installed during site prep is permanent. Culverts, French drains, subsurface drainage pipe, and roadside ditches all need to be in the ground before construction fills in around them. On properties with challenging water management situations — high water tables, springs, properties that receive significant runoff from upslope neighbours — the drainage work during site prep can be substantial. Getting it right is cheaper and easier than excavating around a completed building later to add drainage that should have been there from the start.
Retaining Walls
On sloped properties, retaining walls are often part of the site prep scope — they're what makes a level building platform possible in the first place. They need to go in before the building pad is established above them and before foundation work begins. We've covered the specifics of retaining wall construction for Shuswap properties in a separate guide if that's relevant to your site.
Timing: When to Start and What to Expect
In the Shuswap, the site prep window is largely driven by ground conditions, not calendar dates. The ideal time is late spring — after the frost has left the ground and the worst of the spring mud has passed, but before the hot dry conditions of July and August that make compaction more challenging.
Spring: Plan Early, Start at the Right Time
Spring is when most new construction projects get underway in the Shuswap, and for good reason. The ground is workable, equipment has traction, and completing site prep before summer keeps the project moving. But "spring" in the Shuswap means different things at different elevations and on different aspects — a south-facing bench property at lower elevation can be ready to work in late March or early April, while a north-facing hillside at higher elevation might still have frost in the ground into May. The right time to start is when conditions actually allow proper work, not when the calendar says it should be spring.
Planning happens before all of this. If you're targeting a spring start, the time to get on our schedule and sort out permits is late winter — not April.
Fall: Possible but Constrained
Site prep in fall is possible and sometimes preferred when the goal is getting a site cleared and rough graded before winter so the spring build can start immediately. The limitation is the closing window — once ground conditions deteriorate into freeze-thaw cycles in late October and November, compaction becomes difficult to achieve properly and some phases of work may need to wait. Fall site prep is a useful option if timed correctly; it's a problem if it runs long and gets caught by early winter.
How Long Does Site Prep Take?
A straightforward residential lot — modest clearing, basic grading, no major drainage issues — can often be ready in one to three days. A more complex project — heavily treed acreage, significant earthmoving, retaining walls, and drainage infrastructure — can take a week or more. We provide realistic timelines in the quote, based on what we actually see during the site assessment.
Planning a new build or development in the Shuswap? Call Winco Earthworks at (250) 253-4863 to arrange a site walk — no commitment required.
Permits and Regulations in the CSRD
Whether your site prep project requires permits depends on what you're doing and where. Here's a general overview — but because bylaws and regulations vary by electoral area and lot type within the Columbia Shuswap Regional District, we always confirm what applies to your specific property during the site assessment.
CSRD Building Permits
If site preparation is part of a broader construction project — a new home, garage, or accessory structure — a CSRD building permit is typically required. The permit application covers the structural work that follows, but the site prep work needs to be consistent with what's approved. Starting major excavation or grading before a permit is issued can create problems when the inspector arrives.
Ministry of Transportation Access Permits
Any new driveway connection to a provincial highway requires a Ministry of Transportation and Infrastructure access permit before construction begins. This applies throughout the Shuswap wherever properties access provincial roads — which covers a significant portion of the region. The permit process involves a site review and approval of the access design. We can help you initiate this process as part of planning your project.
Environmental Setbacks and Riparian Areas
Work near watercourses, wetlands, or the foreshore of Shuswap Lake may fall under provincial environmental regulations that restrict how close to the water any ground disturbance can happen. The Riparian Areas Protection Regulation establishes setbacks from streams and lakes that limit where clearing and grading can take place. On lakefront properties or those with creeks crossing them, this is something we look at closely during the site assessment so there are no surprises mid-project.
Frequently Asked Questions
How much does site preparation cost in the Shuswap?
The range is wide and varies with the size of the area to be cleared, the amount of earthmoving required, drainage complexity, and site access. A compact residential lot with modest clearing and straightforward grading is a very different scope from a raw acreage with significant tree clearing, major earthmoving, and extensive drainage work. The most accurate way to get a number is a site visit — we look at what's actually there and quote based on that. We're always happy to do a site walk before any commitment is made.
What happens to the topsoil that's stripped during site prep?
It depends on your plans for the property. Stripped topsoil is usually stockpiled on site and reused later — spread over finished grades for landscaping and revegetation after construction is complete. If there's more than you need, it can sometimes be sold or given away. If it's contaminated with roots and organic debris, it may need to be hauled off. We discuss this as part of planning the project so the topsoil doesn't become an unwanted liability sitting in a pile somewhere inconvenient.
Does every tree and stump need to be removed?
Within the building envelope — anywhere a structure, driveway, septic field, or utility is going — yes. Stumps and roots left in the ground will rot and settle, creating voids that cause structural problems. Outside the building area, it depends on the long-term use. Trees you want to keep can often stay if they're set back from construction activity. Stumps in areas that will eventually be landscaped but have no structural use above them can sometimes be ground rather than fully removed. We'll walk through the clearing scope with you during the site assessment.
What if there's rock on my site?
Rock near the surface is common on hillside properties in the Shuswap. Depending on the size and location, it can sometimes be worked around, but if it's in the path of excavation for a foundation or driveway cut, it needs to be dealt with. Small to medium rock can often be broken and moved with excavation equipment using hydraulic rock breaking attachments. Larger ledge rock or significant bedrock may require specialist contractors — work that involves permitting and coordination well beyond standard excavation scope. We identify rock conditions during the site assessment so the quote reflects the real scope of work.
Can I do some of the site prep work myself to reduce costs?
Hand clearing of brush and small vegetation is something many homeowners take on themselves, and that's reasonable. Anything involving excavation, grading, or heavy equipment is another matter — the risk of disrupting drainage patterns, damaging underground utilities, or creating a subgrade condition that the subsequent contractor can't work with is high enough that it tends to create more cost than it saves. We're also straightforward about what makes sense to DIY versus contract out when we do the site assessment — if there's work you can realistically handle, we'll say so.
In what order does everything happen on a new build?
Generally: site prep and land clearing first, then driveway roughing, then any retaining walls, then foundation excavation, then septic system installation (coordinated with the building permit process), and then finish grading and surface work after the building is enclosed. The exact sequence varies by project — what's going on the property, how the trades are scheduled, and how much of the work is being done by one contractor versus multiple. When we're involved early, we help sequence things so each phase sets up the next correctly.
