Gravel Driveway Construction in the Shuswap

Your complete guide to building a driveway that holds up through Shuswap winters, spring runoff, and years of daily use.

Introduction

Building a new driveway — or fixing one that's turned into a muddy mess every spring — is one of the most common calls we get at Winco Earthworks from Shuswap homeowners. Whether you're building a new home, developing acreage, or just tired of watching your vehicle disappear into a rut, a properly built gravel driveway is one of the best investments you can make in a rural BC property.

What Makes a Shuswap Driveway Different?

The catch? A lot of driveways in the Shuswap fail within a few years — not because gravel doesn't work, but because the groundwork underneath wasn't done right. This guide covers what actually goes into a driveway that holds up through freeze-thaw cycles, spring runoff, and years of regular use.

Key Takeaways

Before diving into the details, here are the essential things every Shuswap property owner should know about gravel driveway construction:

  1. Excavation depth matters more than gravel depth — Stripping topsoil and organic material to 12–18 inches is the most critical step. No amount of surface gravel compensates for a soft, organic subgrade beneath it.
  2. Clay soil is common in the Shuswap and requires a geotextile barrier — Without fabric between the subgrade and base rock, gravel migrates into the ground within a season or two, especially in clay-heavy areas around the valley floor.
  3. Freeze-thaw cycles are the enemy of a poorly drained driveway — Moisture trapped in the base layer expands when it freezes and settles unevenly when it thaws. Proper drainage design isn't optional in a BC interior climate.
  4. Compaction happens in lifts, not all at once — Each layer of base material must be compacted before the next goes down. Skipping this step is the primary reason driveways develop soft spots within the first year.
  5. Surface gravel should be shallow over a deep, well-built base — 2–3 inches of surface gravel over a properly built base outperforms 12 inches of gravel dumped on untouched ground, every time.
  6. Drainage is a design decision, not an afterthought — Crown, cross-fall, side ditches, and culverts all need to be planned before excavation starts, not corrected after the driveway is in.
  7. Permits are required for driveways connecting to public roads — Access to a provincial road requires a Ministry of Transportation permit; connections to other roads may fall under CSRD jurisdiction. We can help you determine what applies to your site.
  8. A properly built driveway lasts 15–20 years with minimal maintenance — The investment is in the preparation phase. Once it's built right, routine upkeep is straightforward and inexpensive.
  9. Spring is the right time to plan, not to wait — Ground conditions in spring allow proper excavation and compaction. Starting a driveway project in late summer on dry, hard soil — or worse, in fall — limits what can be done well.
  10. Local contractors understand local conditions — Soil types, drainage patterns, and spring runoff behaviour vary throughout the Shuswap. A contractor who's worked in your area brings that knowledge to your project.

Why Shuswap Driveways Are Harder Than They Look

The Shuswap isn't a forgiving environment for a poorly built driveway. Between the wet springs, hard winters, and clay-heavy soils in many parts of the region, a driveway that wasn't properly excavated and graded will show its problems fast.

Here's what typically goes wrong:

Clay Subgrade

Large parts of the Shuswap sit on clay-heavy soil. Clay holds moisture, expands when wet, and compresses unevenly under load. Without proper excavation and a geotextile barrier between the soil and your base rock, gravel will slowly sink and migrate into the ground beneath it — usually within a couple of seasons.

Freeze-Thaw Heaving

Moisture trapped in the base layer has nowhere to go when the ground freezes. It expands, pushes the surface up, and when it thaws, the material settles unevenly. This is the main reason driveways develop soft spots and ruts — not just wear from vehicles.

Poor Drainage

A driveway that doesn't shed water properly will channel runoff across the surface rather than away from it. Over time, that erodes the edges, undermines the base, and turns low spots into puddles that freeze solid every winter.

Getting these three things right before a single shovel of gravel goes down is what separates a driveway that lasts 15–20 years from one you're fighting every spring.

Step One: Excavation and Subgrade Preparation

This is the part most homeowners don't see — and the part that matters most.

Before any base material is placed, the existing topsoil and organic layer needs to be stripped out entirely. Topsoil is soft, it holds moisture, and it compresses over time. You cannot build a stable driveway on top of it, no matter how much gravel you add. Depending on the site, this typically means excavating 12–18 inches below finished grade.

Once the organic material is removed, the subgrade — whatever mineral soil is beneath — is graded to establish the correct slope and cross-fall. This is where drainage decisions are made. A driveway should shed water to the sides, not collect it in the middle, and in sloped terrain the grade needs to be shaped to direct runoff away from structures and off the road surface in a controlled way.

In areas with particularly soft or saturated ground, we may also recommend a layer of geogrid reinforcement to stabilize the subgrade before base rock goes down.

Step Two: Base Layers and Aggregate

The base layer is what gives your driveway its load-bearing strength — not the surface gravel. This is where homeowners often shortchange themselves by skipping to the part they can see.

A properly built driveway in the Shuswap typically includes:

Geotextile Fabric

Laid directly on the prepared subgrade, geotextile fabric separates the base rock from the soil below, preventing migration and maintaining drainage over time. It's not optional on clay-heavy ground.

Crushed Base Rock

Pit run or 3" minus base rock is compacted in lifts. The depth depends on soil conditions, expected traffic, and whether you're building a short residential driveway or a longer access road to a rural property. Residential driveways typically need 8–12 inches of compacted base; anything that will see heavier vehicles or equipment needs more.

Surface Layer

Clean crushed gravel, typically 3/4" or similar, is what you drive on and what gives the driveway its finished appearance. It should be relatively shallow — 2–3 inches — over a properly built base. Piling on more surface gravel doesn't compensate for a weak foundation below.

Every lift of base material needs to be compacted before the next one goes on. Skipping or rushing this step is one of the main reasons driveways develop soft spots within the first year.

Step Three: Drainage That Actually Works

Getting water off your driveway — and keeping it off — is the single most important thing you can do to extend its life. In the Shuswap, this is especially true in spring when snowmelt and rain arrive at the same time.

A few things we assess and address on every driveway project:

Crown and Cross-Fall

The surface of the driveway should have a slight slope from the center to each edge — typically 2–4% — so water sheets off rather than pooling. This sounds simple but has to be built into the grading, not added as an afterthought.

Side Ditches

On longer driveways, roadside ditches intercept water running toward the driveway from upslope. Without them, every rainstorm sends a sheet of water across your surface, eroding the edges and saturating the base.

Culverts

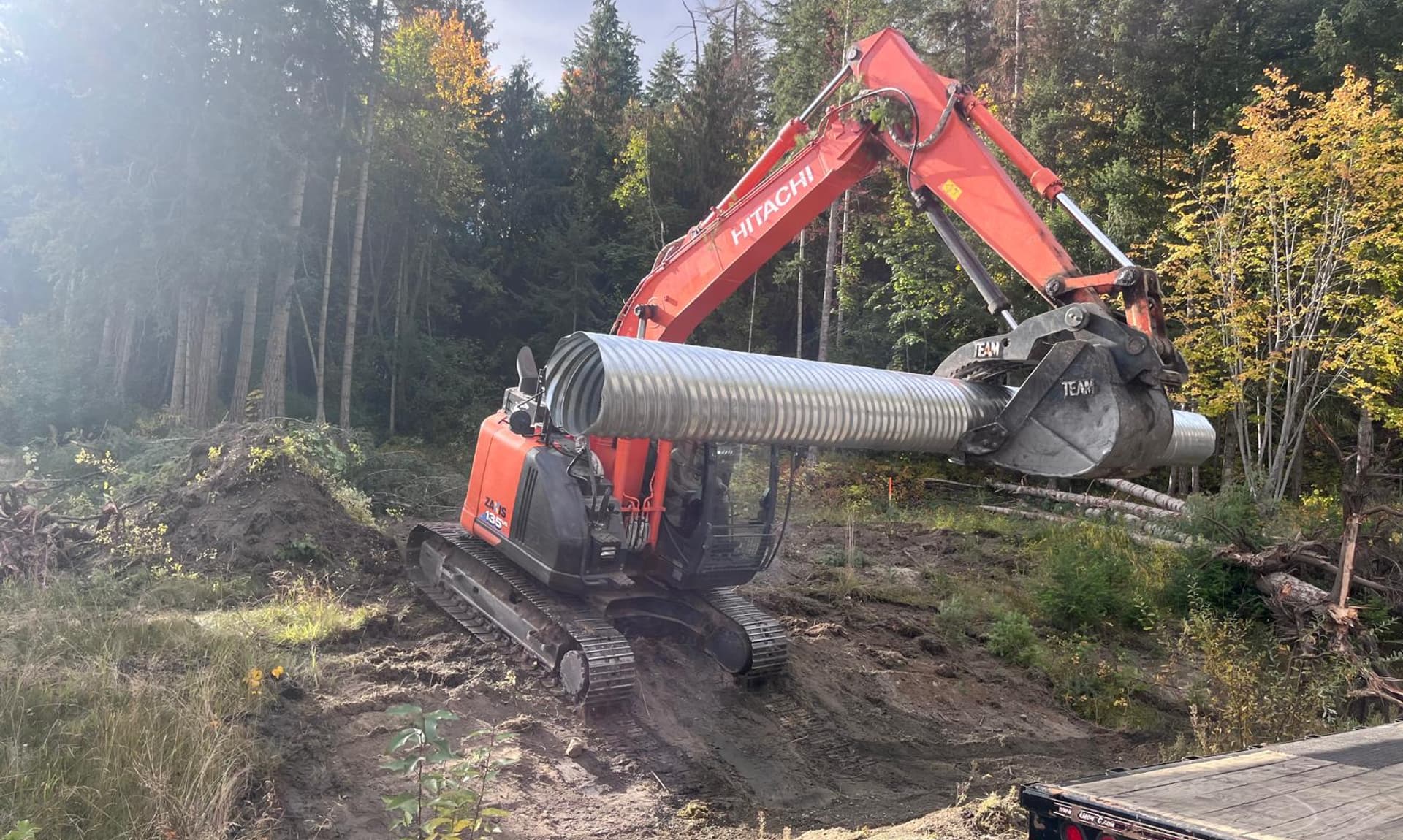

Where natural drainage channels cross your driveway route, culverts are installed to carry water underneath rather than allowing it to flow over the surface. Sizing these correctly matters — an undersized culvert backs up and floods during heavy rain events.

French Drains

In particularly wet areas or where groundwater is an issue, a perforated pipe drain alongside or beneath the driveway intercepts subsurface moisture before it can saturate the base layer.

On larger or more complex sites, we'll walk the property with you before quoting to assess where water moves during spring runoff — because a plan that ignores the natural drainage pattern of the land is going to cause problems regardless of how well the driveway itself is built.

"Dan from Winco Earthworks was a dream to deal with. We needed major drainage work that insurance refused to cover. Dan worked closely with me to control the budget but in the end delivered a great finished product, on time & on budget. Dan returned a couple of times for minor touch ups to ensure the project was done right. One of the biggest things was Dan came the same day when called & quoted the job very quickly. They were able to start immediately and finished within 2 weeks. Overall, 10 out of 10, customer service, cost & workmanship."

— Scott Lebus, Blind Bay, BC

How Long Should a Gravel Driveway Last?

A properly built gravel driveway in the Shuswap should give you 15–20 years of low-maintenance performance with only occasional attention — typically adding a fresh layer of surface gravel every 5–10 years and clearing the ditches annually.

The driveways that fail early almost always have the same backstory: topsoil wasn't removed, the base was too shallow, compaction was skipped, or drainage wasn't addressed. These aren't things you can fix retroactively without essentially rebuilding from scratch.

That's why the Winco Earthworks team puts most of our effort into the preparation phase — the work that's invisible once the job is done, but determines how everything performs for the next two decades.

Ready to build a driveway that lasts? Call Winco Earthworks at (250) 253-4863 for a free site walk — no commitment required.

What About Access Roads and Longer Driveways?

For rural properties with longer access roads — quarter-mile entries, logging road upgrades, or haul routes — the same principles apply, but the scope is different.

Longer roads typically require more formal drainage engineering, wider clearing corridors, and in some cases a proper road bed with subgrade stabilization before base rock is placed. We've built access roads across the Shuswap for acreage developments, rural home sites, and agricultural properties, and we're comfortable working in tight terrain, on slopes, and in areas with limited turnaround room.

If you're planning a new build on raw land, the driveway and access road is usually one of the first things we tackle — getting equipment in and material out during construction is only possible if the road can handle the load.

Frequently Asked Questions

How much does a gravel driveway cost in the Shuswap?

Every project is different, so we're cautious about quoting numbers without seeing the site. The variables that affect cost most are the length of the driveway, the depth of excavation required, the existing soil conditions, and how much drainage work is needed. The best way to get an accurate number is to have us walk the site with you. We're always happy to do that before any commitment is made.

Can I just add more gravel to a driveway that's already sinking?

In most cases, adding surface gravel to a failing driveway is a short-term fix that delays the underlying problem. If the subgrade or base layer is compromised, more gravel will eventually sink into the same soft spots. Depending on the severity, the more cost-effective solution is often to rehabilitate the base rather than top-dress repeatedly year after year.

Do I need a permit to build a driveway in the Shuswap?

For driveways connecting to a provincial road, you'll need a driveway access permit from the Ministry of Transportation. Connections to other roads may fall under CSRD jurisdiction depending on your location. For driveways entirely on private property with no public road connection, permit requirements are generally minimal. We can help you figure out what applies to your specific site before any work starts.

What's the difference between pit run and crushed gravel?

Pit run is natural gravel material as it comes from the ground — a mix of sizes including fines that compact well and make an excellent base layer. Crushed gravel is mechanically processed and typically more angular, which helps it interlock and stay in place on the surface. Both have their place in a properly built driveway, and we source aggregate locally through our hauling operation.

How long does a driveway project take?

A straightforward residential driveway can often be completed in one to two days, depending on length and site conditions. More complex projects — longer access roads, significant drainage work, or challenging terrain — take longer. We'll give you a realistic timeline when we quote the job.

Is spring really the best time to build a driveway?

For most properties in the Shuswap, yes. The ground is workable, equipment has good traction, and getting the job done before summer means you're not managing mud through the driest months. The one caveat is timing around the wettest part of spring — if the ground is saturated, we'll be honest with you about whether conditions are right to proceed.

Ready to Get Started?

Spring is the right time to plan a driveway project in the Shuswap. The ground is workable, and getting the job done before summer means you're not fighting mud all season.

"Daniel quickly identified the problem and clearly defined the scope of work. He provided timely updates on both progress and costs, demonstrating a high level of professionalism. I look forward to continuing our relationship."

— Damien Dufour, Tappen, BC

If you've got a new build coming up, an existing driveway that needs rehabilitation, or raw acreage that needs an access road, we'd be glad to take a look. Give us a call or send us a message and we'll arrange a time to walk the site with you — no obligation, no pressure.
